Contractors’ Tampa Bathroom Remodel Timeline

Contractors’ Tampa Bathroom Remodel Timeline

Most like-for-like bathroom remodels need three to six weeks of active construction and six to twelve weeks from first design meeting to final walkthrough, according to UrbanSplatter’s timeline research. Three separate clocks run during any project: construction days, total project time, and how long the room stays unusable. Scope, material lead times, and whether plumbing moves determine which end of that range you land on.


TL;DR:

  • Ordering custom vanities and glass early, within the first week of signing, prevents delays caused by long lead times at the end of the project.
  • Pre-construction planning, including permits and fixture selections, typically takes 2 to 6 weeks and often causes the most scheduling surprises.
  • Hidden damage discovered during demolition, such as mold or rot, can add days or weeks to the timeline if not addressed immediately.
  • Bathroom scope significantly influences total duration, with full remodels lasting up to 12 weeks and master baths with layout changes up to four months.
  • The most common delays stem from late material orders, vague selections, inspection scheduling issues, hidden damage, and subcontractor scheduling gaps.

Elite Builder Renovation
Plan Your Tampa Bathroom Remodel
Elite Builder Renovation guides your project from initial consultation to completion, with clear communication and expert execution.

Explore bathroom remodeling

Table of Contents

What Determines Your Bathroom Remodel Timeline?

Every bathroom remodel timeline runs on three separate clocks, and confusing them is why homeowners feel blindsided by delays that were never actually delays.

Active construction time is the days a crew is physically on site: demo, framing, plumbing, tile, finishes. Total project time stretches wider. It includes design meetings, material ordering, permit review, and the lead times that happen before a single hammer swings. Room-unusable window is the practical number your family actually feels. It usually starts a few days before construction begins, once fixtures are disconnected, and ends when the space passes final inspection.

Rough ranges by scope:

  • Cosmetic refresh (paint, fixtures, vanity swap): 3 to 7 days of construction, 2 to 4 weeks total
  • Powder room update: 5 to 10 days of construction, 3 to 5 weeks total
  • Hall or secondary bath, like-for-like: 2 to 3 weeks of construction, 5 to 8 weeks total
  • Full like-for-like bathroom remodel: 3 to 6 weeks of construction, 6 to 12 weeks total
  • Master bath with layout changes: 6 to 8 weeks of construction, 3 to 4 months total

Which clock matters most depends on your household. A single-bathroom home cares most about the unusable window. A family with a second bath cares more about total project time and how it lines up with school schedules or holidays.

Phase-by-Phase: What Happens Week by Week

A bathroom remodel timeline is really a sequence of checkpoints, and several of them are outside your contractor’s control. Knowing which is which helps you tell a normal wait from an actual problem.

Pre-construction: the phase most homeowners underestimate

Before any demolition starts, you need finalized model numbers on every fixture, tile, and vanity, submitted permit applications, and confirmed delivery dates from suppliers. Kitchen Design Partners found that pre-construction planning typically runs 2 to 6 weeks for a mid-range remodel, longer if permits or custom items are involved. This is the single biggest block homeowners miscalculate, because it’s invisible. No dust, no crew, no visible progress. But skipping ahead here is what causes week-three surprises.

Demolition and discovery

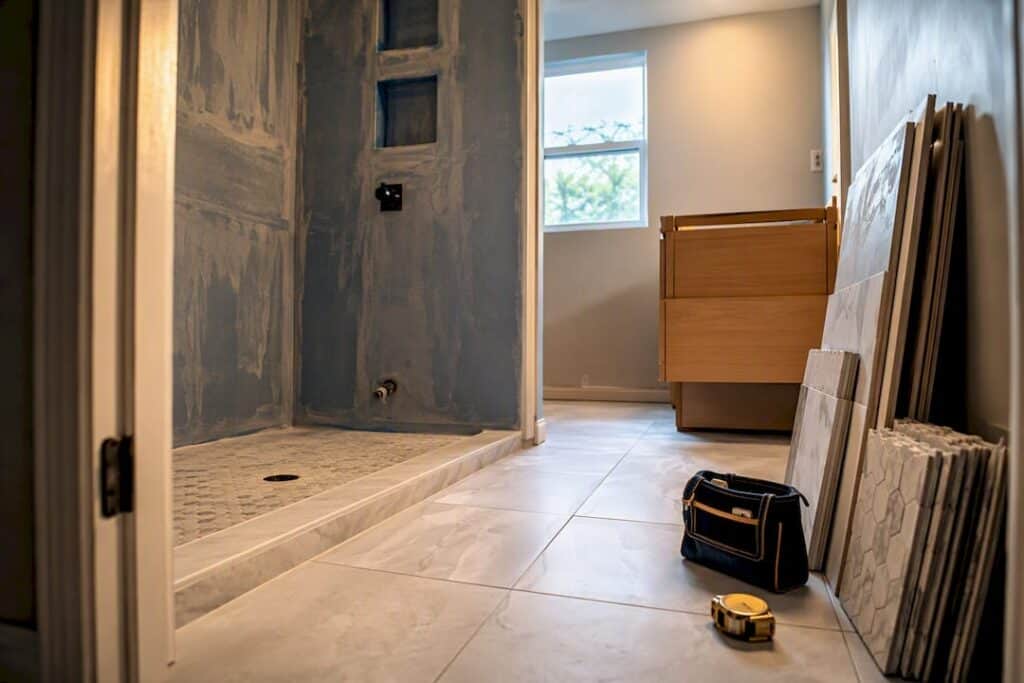

Demo itself usually takes 1 to 3 days for a standard bathroom, according to Thornapple Construction’s phase breakdown. This is also when hidden problems surface: soft subfloor, old cast-iron plumbing, or moisture damage behind tile that nobody could see during the estimate walkthrough. If your contractor finds mold or water damage, remediation should follow EPA cleanup guidance, which can add several days to a couple of weeks depending on how far it spread. Reading through Elite Builder Renovation’s demolition prep guide before your start date helps you understand what a contractor checks for and why some findings stop work entirely until resolved.

Rough-in: plumbing, electrical, and the inspection wall

Rough-in plumbing and electrical work generally takes 3 to 7 days. This phase includes at least one municipal inspection, and that inspection is non-negotiable. No amount of scheduling pressure moves an inspector’s calendar. Ask your contractor how they coordinate inspection requests in your jurisdiction, since Pinellas County and Hillsborough County have different average turnaround windows depending on season and staffing.

Waterproofing and mortar-set showers

Waterproofing membranes and backer board typically take 2 to 4 days to install and cure properly. If you’re doing a mortar-set (traditional mud) shower pan instead of a prefabricated base, add cure time before a flood test, where the pan is filled with water for 24 hours to confirm no leaks. Skipping this step is one of the most expensive mistakes a bathroom remodel can make, since a failed shower pan means tearing out finished tile later.

Tile setting and grout cure

Wall and floor tile installation runs 5 to 10 days including cure time, per Thornapple’s schedule data. Mosaic or intricate patterns push toward the higher end. Grout needs to cure before grout sealer goes on, and sealer needs to cure before the shower sees regular water exposure, so this phase has built-in waiting periods even when the crew isn’t physically present.

Finishes, glass templating, and the punch list

Frameless shower glass can’t be measured until tile is fully set, and fabrication after templating typically takes 2 to 4 weeks. This is the most common reason a “finished” bathroom sits without a shower door for weeks. Final finishes, fixture installation, and the punch list walkthrough usually take 2 to 4 days once glass and any custom items arrive.

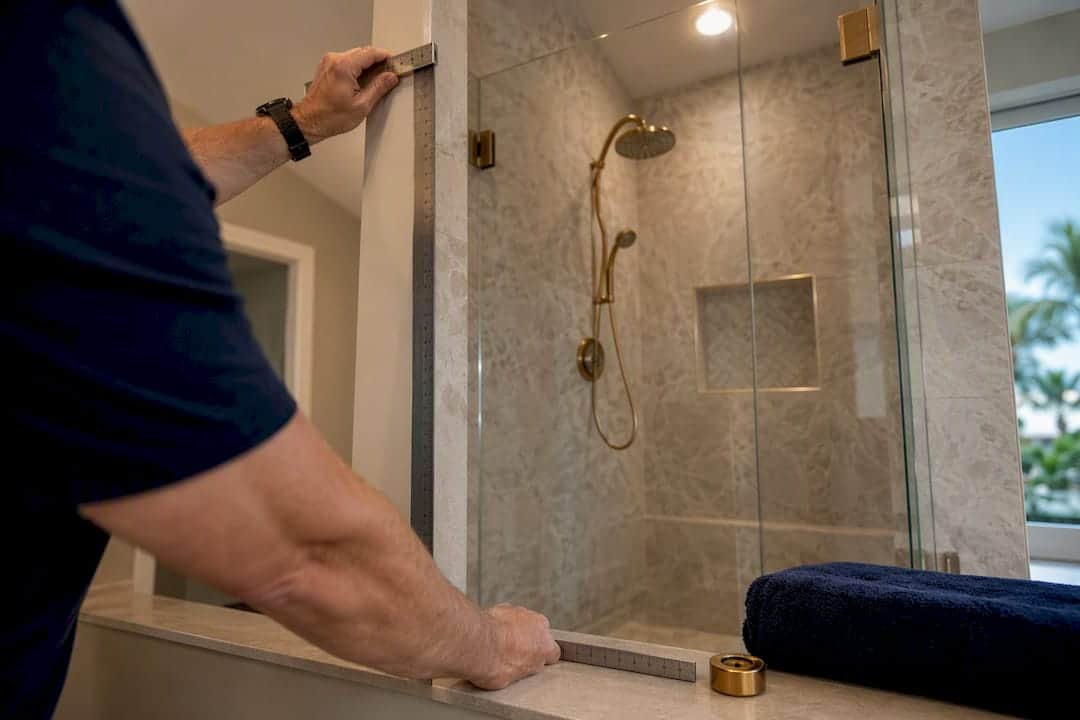

Glazier measuring finished shower opening

How Long Does Each Bathroom Remodel Scope Take?

Once you know your scope, the calendar math gets much more concrete. Here’s how active construction, total project time, and the unusable-room window typically break down.

Scope Active Construction Total Project Time Room Unusable
Cosmetic refresh 3–7 days 2–4 weeks 3–7 days
Powder room 5–10 days 3–5 weeks 5–10 days
Hall/secondary bath, like-for-like 2–3 weeks 5–8 weeks 2–3 weeks
Full bath, like-for-like 3–6 weeks 6–12 weeks 3–6 weeks
Master bath, layout change 6–8 weeks 3–4 months 6–9 weeks

Custom vanities are the biggest wildcard on this table. NAHB reporting indicates that custom vanity lead times can be lengthy, meaning you often need to order one before design is even fully locked. Specialty and imported tile can add multiple weeks beyond standard stock options, and frameless glass adds its own 2 to 4 week tail at the end.

Some work can run in parallel to shave time off the total. Ordering the vanity and glass measurements template while demo and rough-in happen elsewhere in the house, for instance, keeps those long lead items from stacking on top of construction days instead of running alongside them.

What Causes Bathroom Remodel Delays?

Most schedule slips trace back to five causes, and four of them are within your control.

  1. Late material orders. Order custom vanities, specialty tile, and glass the moment design is locked, not after demo starts. Confirm delivery windows in writing, not verbally.
  2. Selections left undecided. Contractors and designers agree that vague selections, rather than exact model numbers, cause the most cascading delays, according to Residential Design Magazine. Freeze every finish choice before demo day.
  3. Uncoordinated inspections. Ask your contractor how far in advance they schedule inspection requests in your county, and whether they batch multiple inspections to reduce dead time.
  4. Hidden damage. Mold, rot, or outdated wiring found during demo needs a contingency fund and a fast response plan, not a scramble.
  5. Subcontractor scheduling gaps. Ask your contractor directly whether their plumber, electrician, and tile setter are on staff or subcontracted, and what their backup plan is if one falls behind.

Pro Tip: Get your vanity and glass orders placed the same week you sign your contract, even if demo is still a month out. Those two items alone cause more finish-date slippage than anything else in a typical remodel.

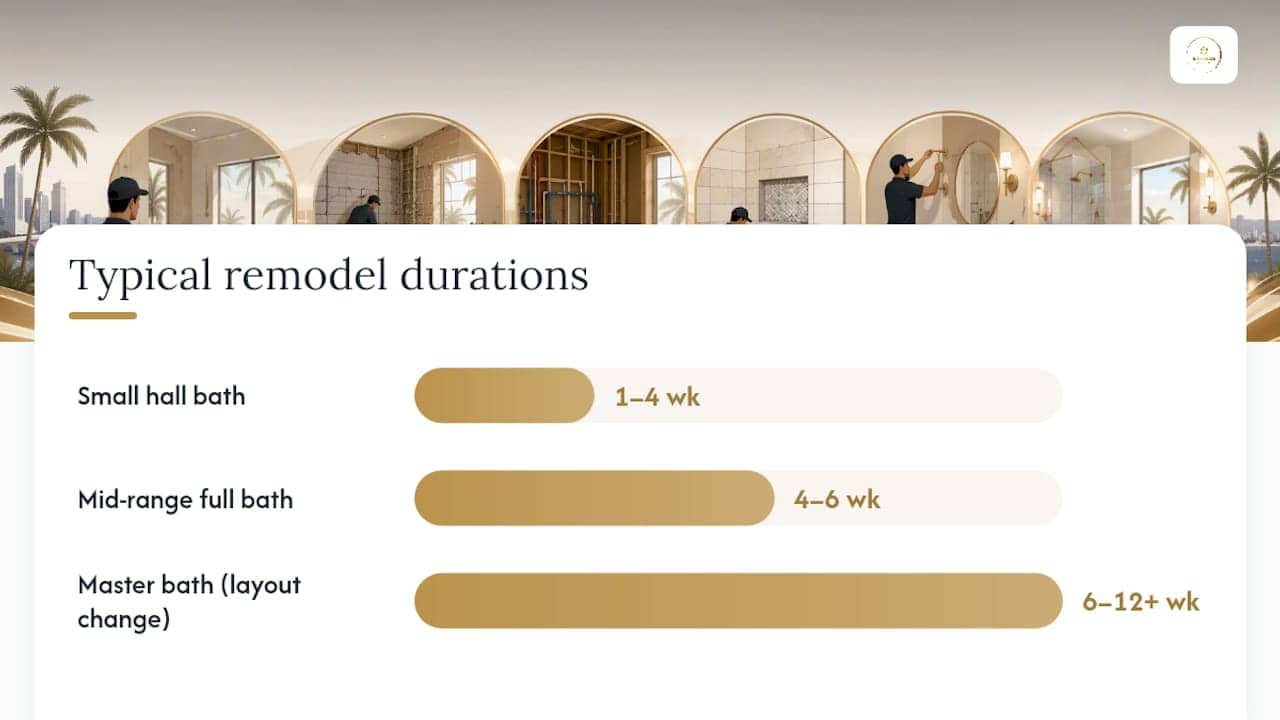

Sample Week-by-Week Bathroom Remodel Schedules

Sample Week-by-Week Bathroom Remodel Schedules — overview diagram

These templates are starting points. Share them with your contractor and adjust based on your specific fixtures and permit timeline.

Small hall bath (1 to 4 weeks of construction):

  1. Days 1 to 2: Demo and disposal
  2. Days 3 to 5: Rough-in plumbing and electrical, inspection scheduled
  3. Days 6 to 8: Waterproofing, backer board, inspection passed
  4. Days 9 to 14: Tile installation and grout cure
  5. Days 15 to 18: Fixtures, paint, punch list

Mid-range full bath (4 to 6 weeks of construction):

  1. Week 1: Demo, discovery, rough-in begins
  2. Week 2: Rough-in inspection, waterproofing starts
  3. Week 3: Tile installation begins
  4. Week 4: Tile cure completes, glass templating happens
  5. Weeks 5 to 6: Glass fabrication wait, fixtures installed, final punch list

Master bath with layout change (6 to 12+ weeks):

  1. Weeks 1 to 2: Demo, framing changes, plumbing relocation rough-in
  2. Weeks 3 to 4: Rough-in inspections (may require two passes), waterproofing
  3. Weeks 5 to 7: Tile installation across larger footprint
  4. Weeks 8 to 10: Custom vanity delivery and installation, glass templating
  5. Weeks 11 to 12+: Glass fabrication buffer, final finishes, punch list

Build in non-negotiable checkpoints for every template: the rough-in inspection, the flood test if you have a mortar-set pan, and grout cure time before sealing. None of those can be rushed regardless of how motivated your crew is.

Bathroom Remodel Planning Checklist

Before demo day, confirm the following:

  • Exact model numbers for every fixture, tile, and vanity, not general descriptions
  • Written delivery confirmations for all custom or long-lead items
  • Copies of submitted and approved permits
  • Proof of your contractor’s insurance and license

Build a contingency fund of at least 10 to 15% of your total budget, and push that toward 20% if your home was built before 1990 or you’re opening walls for the first time. Rough budget signposts: a $5,000 remodel typically covers a cosmetic refresh only, with a 2 to 4 week timeline. A $10,000 project fits a modest hall bath update, running 5 to 8 weeks total. A $20,000 budget supports a full like-for-like remodel with mid-range finishes across the 6 to 12 week range. Reviewing common bathroom remodel mistakes before you finalize your budget helps you avoid the change orders that blow through contingency funds fast.

Why These Timelines Hold Up in Real Projects

Elite Builder Renovation has completed more than 375 remodeling projects across the Tampa Bay area over more than a decade in business, and the schedules above reflect what actually happens on site, not marketing copy. Ordering custom vanities and glass immediately after design lock, planning punch-list walkthroughs before finishes even begin, and relying on established local trade relationships in Pinellas County and Hillsborough County all shave real weeks off a project timeline.

For a full walkthrough of how each construction stage fits together, the step-by-step bathroom remodel guide breaks down what happens at every phase. Homeowners in Tampa, St. Petersburg, Clearwater, and Safety Harbor can also review the bathroom remodeling Tampa service page for details on local permitting support and sourcing practices.

Get a Written Bathroom Remodel Timeline for Your Home

Generic ranges only get you so far. Every bathroom has different plumbing, different permit requirements, and a different set of finish decisions that shape the real calendar. Elite Builder Renovation backs every quote with a written timeline estimate built from your actual fixtures and layout, not a template pulled from an average project.

If you’re weighing a bathroom against a larger project, the full home remodeling services page covers how combining scopes can actually shorten total downtime compared to tackling rooms one at a time. For general procurement advice on why locking selections early matters across any renovation, Rock Doctor’s guide to renovation prep covers similar principles that apply to bathrooms as much as kitchens.

Start with the bathroom remodeling page to request your free consultation and get a written schedule specific to your Tampa Bay home.

Sources

FAQ

How long does a typical bathroom remodel take?

Active construction usually takes 3 to 6 weeks for a full like-for-like remodel, while the total project, including design and permits, typically runs 6 to 12 weeks.

What does a $10,000 bathroom remodel look like?

A $10,000 budget generally covers a modest hall bath update with standard fixtures and tile, completing in roughly 5 to 8 weeks total.

Is $5,000 enough to remodel a bathroom?

A $5,000 budget typically only stretches to a cosmetic refresh, such as new fixtures, paint, and a vanity swap, rather than a full gut renovation.

What is the hardest part of a bathroom remodel?

Pre-construction planning is the phase most homeowners underestimate, since finalizing selections, confirming lead times, and clearing permits can take 2 to 6 weeks before any visible work begins.
